Prepared from the City’s own production · September 19, 2026

What Happened, Step by Step

How a five-acre plant becomes a fifty-eight-acre consolidation. 50 Roelker Road, Wright City, Missouri.
In one paragraph
The plant was about five acres, with future expansion hoped for on Lot 5 — 33 acres when the Commission saw it, 36.4 when the Board approved it. That expansion was not granted. It was withheld by Condition 3, subject to a later amended site plan and further review. Conditions and oversight were the whole point.
Once the six parcels consolidate into one, Condition 3 has nothing left to limit. There is no Lot 5. The expansion is no longer confined to 36.4 acres, because the boundary that confined it will not appear on the recorded plat. And every percentage limit in the Code — 40% open storage, 75% coverage — will be measured against the whole 58 acres.
The applicant has said the front parcels will remain untouched. The City’s own fee email records it the same way: “there is no vertical construction proposed on the front parcels at this time.” That is a present intention, not a restriction, and after consolidation there is no lot line making it one.

Below is how that happened, in order. Each step names the record it rests on, or says plainly that no record has been produced.

Step 1 · June 13, 2025

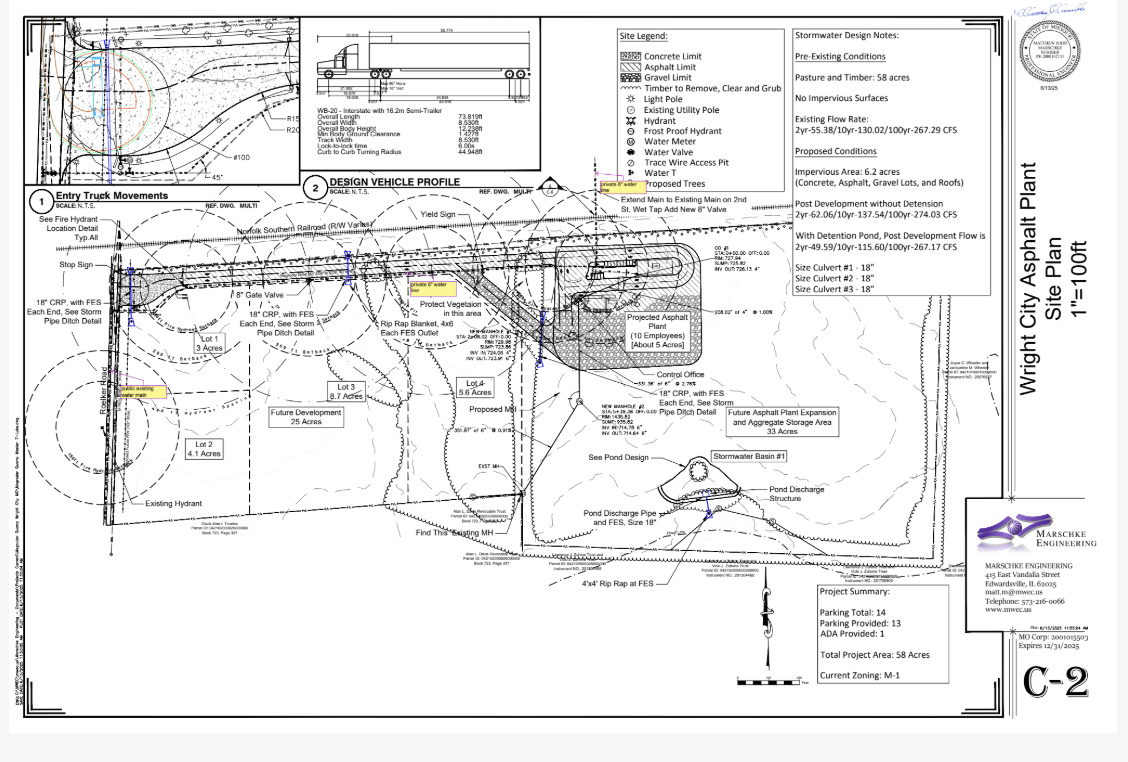

The plans are drawn
Sheet C-2 shows a plant block annotated “Projected Asphalt Plant (10 Employees) [About 5 Acres].” Sheet C-1 labels a separate area “Future Asphalt Plant Expansion and Aggregate Storage Area — 33 Acres.”
Step 2 · August 15, 2025
The City sends the packet
The Commission receives the June 13 set for its meeting.
Step 3 · August 18, 2025
Planning and Zoning votes
On that set. This is the Commission’s only recorded action on the project.

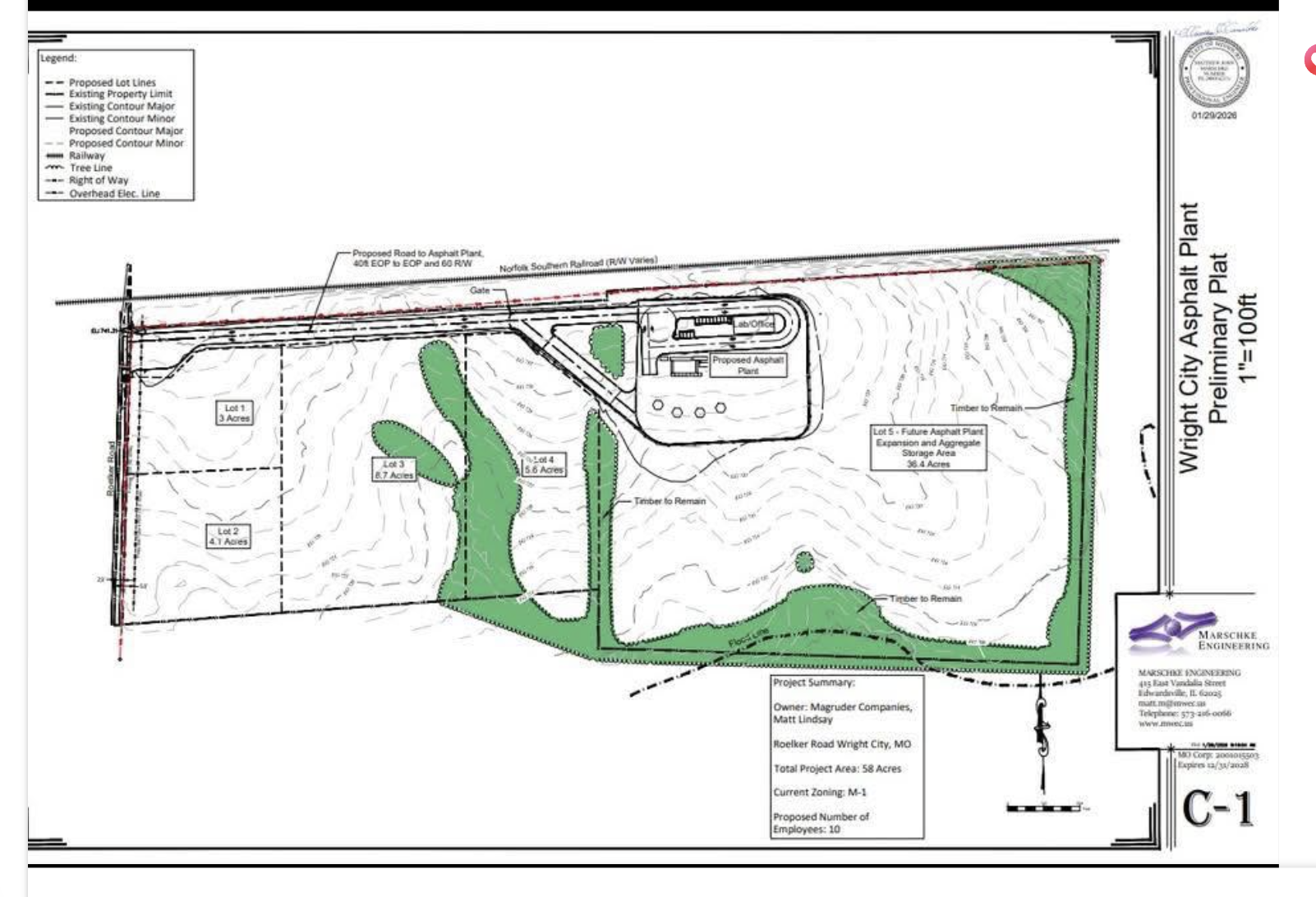

Step 4 · January 29, 2026
A new set appears, with the area 3.4 acres larger
Lots are now numbered and measured: 3, 4.1, 8.7, 5.6, and Lot 5 at 36.4 acres — 3.4 acres larger than what the Commission reviewed. The Project Summary states “Total Project Area: 58 Acres” and “Current Zoning: M-1.”
The petitioners have located no record that this set was ever presented to the Commission.

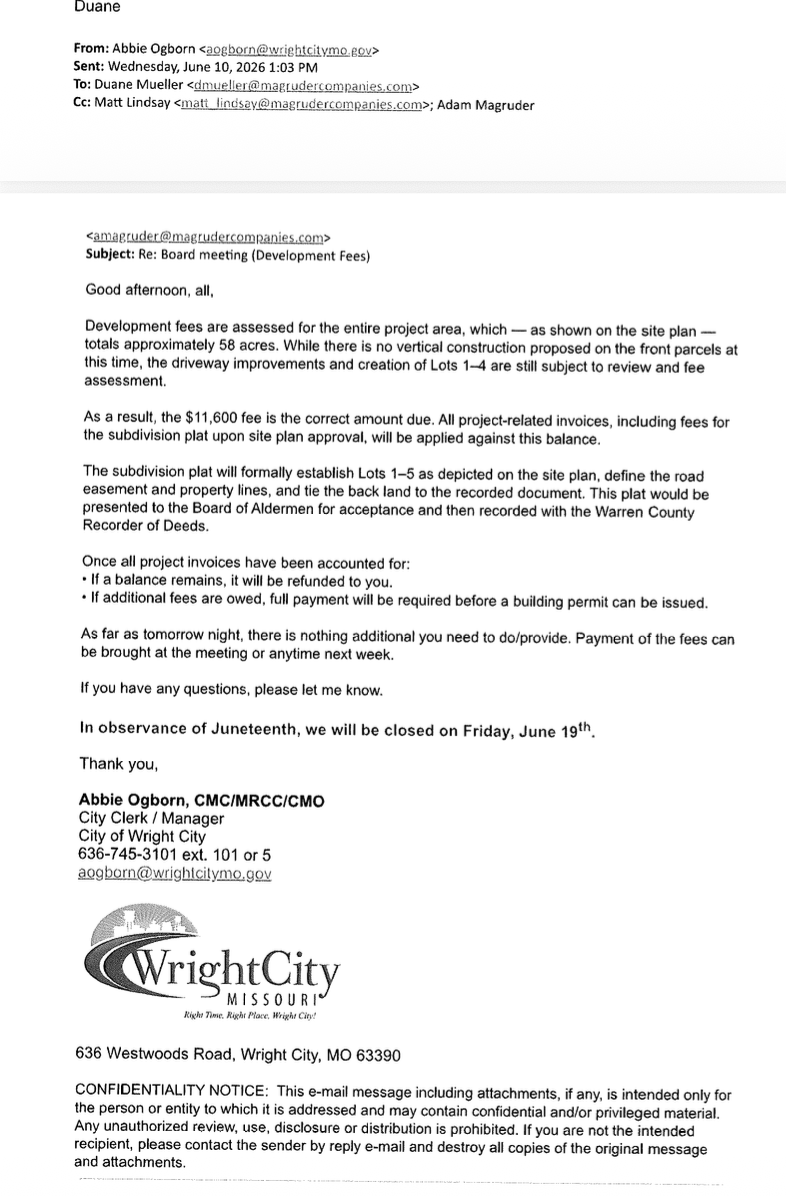

Step 5 · June 10, 2026
The City sets the fee on 58 acres, and says the plat will create five lots
Writing to the applicant the day before the vote: development fees “are assessed for the entire project area, which — as shown on the site plan — totals approximately 58 acres,” and the $11,600 fee is correct. And: “the subdivision plat will formally establish Lots 1–5 as depicted on the site plan, define the road easement and property lines, and tie the back land to the recorded document.”
Step 6 · June 11, 2026
The Board approves, 3–1, on five conditions
Condition 2. A boundary adjustment plat “to consolidate the existing six lots into one” and reflect a 90’ right-of-way dedication, prior to any development or building permits being issued.
Condition 3. The approval “does not approve any future expansion or storage areas as indicated on the note on Lot 5 or otherwise”; an amended site plan would be required first.
Condition 4. The approval “does not approve a subdivision plat or creation of the lots shown as Lots 1-5”; those lots are “conceptual only.”
The contradiction opens here. The day before, the City told the applicant the plat would create Lots 1–5 and billed the fee accordingly. The Board then declined to create them and directed that the six parcels become a single lot instead.
And the unit of measurement changed with it
Conditions 3 and 4 withhold the expansion area and decline to create Lots 1–5. Condition 2 then merges the six parcels into one. Read together, the approval keeps the limits but removes every boundary the limits were to be measured from: no Lot 4 to contain the plant, no Lot 5 to identify the withheld area, no interior lines at all — only the outer edge of 58 acres.
The conditions were written to protect the City. In this order they do the opposite: staying “within the approved area” becomes unenforceable, because after the plat there is no approved area on any recorded document — only one lot, and a percentage of it.

Step 7 · July 8, 2026
The note is removed from the plans
The revised civil set shows no future expansion or aggregate storage area anywhere on the property, and no replacement location. This is the set now before the Commission.
Step 8 · July 10, 2026
Residents file for Board of Adjustment review
Written requests filed within thirty days of the June 11 decision. Residents had asked for application forms on earlier occasions and were not provided them. Some filings were acknowledged; others were not.
The filings and any acknowledgements are held by the individual residents who submitted them. No City record of these filings has been produced to the petitioners.
Step 9 · July 16, 2026
The City declines to docket them
On the ground that no administrative zoning determination had been made that was subject to Board of Adjustment review.
The City’s written position on Board of Adjustment review: City response, July 1, 2026. The July 16 communication declining the filings is not among the records produced to the petitioners; this step rests on the petitioners’ own copies of that correspondence.
Step 10 · August 6, 2026
The City confirms what its file does not contain
No §405.560 open-storage calculation. No building-coverage calculation. No §405.100(A)(7) desirability review. And, asked for any document fixing the plant’s location and setbacks, the City was “unable to determine the specific records being requested.”
Step 11 · August 17, 2026
Planning and Zoning tables the plat
No minutes or agenda for this meeting have been produced to the petitioners. A records request for the August 17 agenda and meeting materials is outstanding.
Step 12 · September 21, 2026
It returns to the Commission
Condition 2 makes this plat the last approval before permits can issue.

Two paths from Monday

Monday, September 21 · 6:00 PM
Planning & Zoning votes on the consolidation plat
Condition 2 makes this the last approval before permits can issue.
↓ If the plat is approved
Six parcels become one
A single lot of approximately 58 acres is recorded.
Condition 2 is satisfied
The last condition clears. Development and building permits may issue.
Lot 5 ceases to exist
Condition 3 withholds “the note on Lot 5.” After consolidation there is no Lot 5 for it to name.
The percentage caps grow
§405.560 allows open storage on 40% of the lot. Forty percent of 58 acres is about 23 acres.
An amended site plan returns here
Condition 3 requires one before expansion. It would come back to this Commission — measured against a 58-acre lot.
Conformity is assumed
§410.010(I) required it to be established before approval. After approval there is no stage left at which to ask.
↓ Or, If the plat is denied
Nothing is decided about the project
Denial does not reject the plant. It returns the plat for the work the Code requires.
The six parcels stand as they are
Percentage limits continue to be measured against the existing parcels, not a 58-acre whole.
Condition 3 keeps its referent
The withheld area can still be identified by the note the condition names.
The conformity question stays open
The City can produce the plan, the measurements and the determination §410.010(I) requires — or state that none exist.
The applicant may refile
With a plat that identifies the operating area, its boundary, and the calculations behind it.
The difference between the two paths is not whether the plant is built. It is whether the questions the Code requires are answered before the last approval, or assumed after it.

What can happen on Tuesday

Condition 3 does not forbid the future expansion and storage area. It defers it: “an amended site plan would need to be submitted and approved before any expansion or other additional future development of the site.”

So the applicant may return at any time with an amended site plan showing the future expansion and storage area. That amended plan would come back through this Commission, as the original did in August 2025 before the Board acted. The review would happen. The question is what standard it would be measured against by then.

Why Monday’s vote decides how easy that is
Section 405.560 caps open storage at 40% of the lot and building coverage at 75% of the lot. Both are percentages. Both are measured against whatever the lot is.
Today — six parcels
about 2 acres
Forty percent of a five-acre plant area. DNR records 1.5 acres of piles, so the operation barely fits — before any truck circulation.
After consolidation — one parcel
about 23 acres
Forty percent of 58 acres. The same Code section, the same percentage, applied to a lot ten times larger.
The limits do not change. The lot they are measured against does. Consolidating six parcels into one enlarges the denominator, and every percentage cap in the Code grows with it. When the amended site plan returns to this Commission, the storage it proposes will be measured against 58 acres — and on that arithmetic, almost any amount of storage complies.
How the plan crept from five acres to fifty-eight
Five acres — the plant block the Commission reviewed in 2025, annotated “About 5 Acres” with no boundary drawn around it.
Eight acres — the figure described aloud after the approval. No plan, calculation or record states it.
Forty-one acres — the plant block plus Lot 5’s 36.4-acre future expansion and storage area, as the Board’s own sheet depicted them.
Fifty-eight acres — the project area the sheet states, the acreage the City billed, and the parcel Monday’s plat creates.
At no point did anyone approve an expansion. Each step was procedural: a revised sheet, a fee calculation, a boundary adjustment. The operating area grew anyway, because nothing in the record ever fixed where it ended.

What the order of operations changed

The plat was supposed to come first. It is coming last. The effect is that the project was reviewed at one scale and will be governed at another.

Every discretionary review — the Commission’s recommendation, the desirability assessment, the Board vote — happened while the project was described as a five-acre plant. Every enforceable limit will be applied after the lot becomes 58 acres. The review saw the small number; the Code will measure against the big one. Nothing in between required anyone to reconcile them.

Either order produces a fixed subject. This one produces none.
The site plan was measured against lots that did not exist, and the lots will be created after the measuring is over.

What that means on the ground

The limits that protect neighbors are not abstractions. Nearly all of them are measured from a lot line, and consolidation moves the lot line outward to the perimeter of the whole property.

The front parcels stop being a buffer
Lots 1, 2 and 3 — about 15.8 acres along Roelker Road — sit between the plant and the road. As separate parcels they are separate property. As part of one consolidated lot they are simply the front of the operating parcel, and nothing in the Code keeps activity off them.
Screening and fencing move to the outer perimeter
Section 405.540(A)(4) requires an opaque screen where industrial abuts residential. On one 58-acre lot that obligation attaches at the outside edge of the whole property — the boundary nearest homes, common ground and Roelker Road — not at the edge of a small plant lot set back in the middle of the site.
Dust, odor, noise and vibration are measured at a property line that moved
Sections 405.090 and 405.530 limit these at the property line. Consolidation does not loosen the standard; it relocates the line. Operations may move outward within the parcel — nearer to homes, nearer to the road, nearer to the school route — while remaining, in Code terms, entirely inside the lot.
Distance was doing the work no condition was written to do
What protects the nearest homes today is not a setback or a screen. It is the fact that the plant sits back from the road behind three other parcels. That protection is a function of the lot lines, and it ends when the lot lines do.
Had the plat come first, the Code’s limits would have had a number to work with. Because it came last, the project was approved as five acres and will be regulated as fifty-eight — and no one ever had to vote on the difference.

What else was never determined

Every requirement below is measured against a lot, or was required to be reviewed before approval, or both. The status column states what the City’s written responses say, not what the petitioners conclude.

Dated as of the records produced. The status column reflects the City’s written responses and the documents produced to the petitioners through August 6, 2026. Nothing later has been produced. Several items — particularly the plat review items identified on July 15 — may since have been addressed in records the petitioners have not seen. Where that is so, the petitioners ask only that the resolving document be identified by date and name.
Code What it requires What the record shows
§405.560(A)(5)(b)Open storage of raw materials limited to 40% of the lotNo calculation located
§405.560(A)(5)(a)Buildings limited to 75% coverage of the lotNo calculation located
§405.100(A)(7)Commission shall assess the desirability of the use in the districtNo record of review
§405.520 · §405.540(A)(3)50-ft height cap, and a step-back of 1 ft for every 2 ft above 30 ft where industrial adjoins residentialNo heights stated on any plan
§405.540(A)(2)Nothing over 6 ft within 30 ft of a road right-of-wayNot addressed in the record
§405.540(A)(4)Opaque screening where industrial abuts residentialTree line runs interior, not at the boundary
§405.090 · §405.530Dust, odor, noise and vibration limits at the property line, separate from the State air permitNo review located; Condition 5 defers to nuisance codes
§405.510(A)(5)Conditional use and public hearing for flammable-liquid storage72,000 gallons on site; no CUP sought
§405.070 · §405.080(A)(2)(c)A use not listed as permitted or conditional is “specifically prohibited”Asphalt plant appears on neither list
§405.560 vs §405.570Whether raw-aggregate processing belongs in M-1 or M-2No written use determination produced
Chapter 412Stream buffer requirementsOpen on the July 15 review; no closing record produced
§410.010(G)Plat review and recommendation by the CommissionJuly 15 review flagged tax certification, abstract of title, an unlabeled tract and state-plane coordinates; no closing record produced
§405.020 · §405.030Zoning to lessen street congestion and protect district characterTraffic study recommendations reportedly not adopted; entrance relocated beside the railroad
What these have in common. Nine of the thirteen are measured against a lot or a lot line. They were not waived and they were not decided. They were deferred past the approval that was supposed to apply them, and the plat that would fix the lot is the same act that closes the sequence.
The Commission’s own supplemental regulations say §405.100 “must be reviewed in every case when considering any type of land use within the City’s jurisdiction.” The City has confirmed it holds no record that subsection (A)(7) was applied here.
The full Codes in Question board, with sources for each →
The code sections this turns on
Wright City Code §410.010(G) — Commission review
The boundary-adjustment plat is submitted to the Planning and Zoning Commission for review and recommendation.
Wright City Code §410.010(I) — zoning conformity
All plats reviewed under Chapter 410 must conform to the applicable provisions of the Zoning Code before record-plat approval by the Board of Aldermen.
This is the provision the two questions rest on. It places the conformity determination before approval, not after.
Wright City Code §405.560(A)(5) — M-1 limits
In M-1 Light Industrial, open storage of raw materials is limited to 40% of the lot (subsection b), and principal and accessory buildings may cover no more than 75% of the lot (subsection a).
Both limits are percentages of a lot. Consolidation changes the lot.
Also engaged
§405.100(A) — supplemental regulations that “must be reviewed in every case when considering any type of land use”; §405.100(A)(7) — the Commission “shall base its consideration on” the purpose and intent of the chapter and on “assessing the desirability of said use therein.” The City has confirmed it holds no record of a §405.100(A)(7) review. §405.520 and §405.540 — height, step-back and setback limits, also measured from lot lines.
Quoted and summarized from the adopted Wright City Code, checked September 19, 2026. Read each section against the current adopted text before relying on it. The full Codes in Question board →
What conformity review is for
Section 410.010(I) requires a plat reviewed under Chapter 410 to conform to the Zoning Code before the Board approves it. That requirement exists precisely to catch this: a plat that changes what the Code’s limits are measured against.
It cannot do that job after the fact. Once the plat is approved, conformity is assumed — for a plant whose area no document fixes, on lots the approval says were never created.
What the consolidation actually accomplishes
Two things happen at once, and neither is a decision anyone votes on.
One · Conformity is bypassed, because no stage is left for it
The City said in July that no administrative zoning determination had been made, so there was nothing to appeal. Section 410.010(I) puts the determination here, before record-plat approval. If it is not made Monday, it is not made anywhere. The requirement does not fail loudly; it simply runs out of proceedings in which it could have been satisfied.
Two · The denominator becomes the whole 58 acres
Every limit that matters here is a percentage of the lot. The project was introduced, reviewed and approved as a small asphalt plant of about five acres. After consolidation there is one lot of 58 acres, and the same 40% open-storage cap that allowed roughly two acres will allow roughly twenty-three.
Nobody will have approved an expansion. The plant will still be described as five acres. But the review that was supposed to test it will have passed without occurring, and the number it would have been tested against will have grown more than tenfold.
Does the plant even fit? →
The three plans, side by side →
Every source document →
All four petitions, volume by volume →
Home →
Every document cited is published at wright-city-neighbors.netlify.app. The 40% and 75% figures are the caps stated in §405.560; the acreages are taken from the plan sheets and the City’s June 10, 2026 fee email. Whether consolidation has the legal effect described is a question for counsel, not a resident conclusion.
